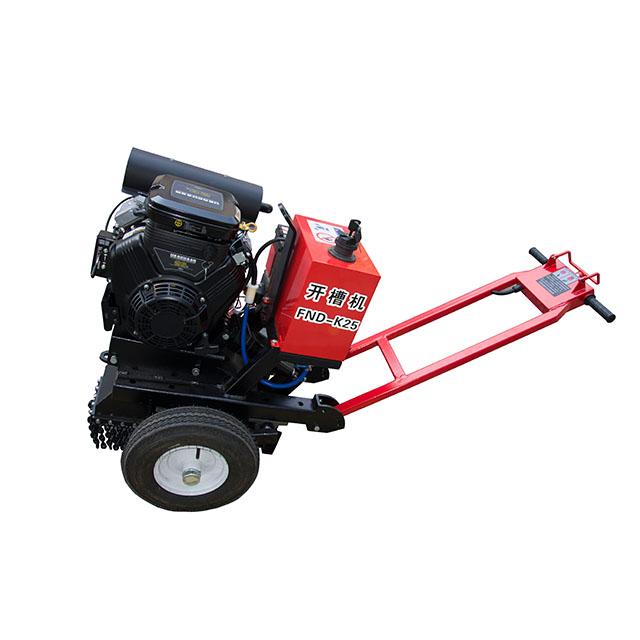

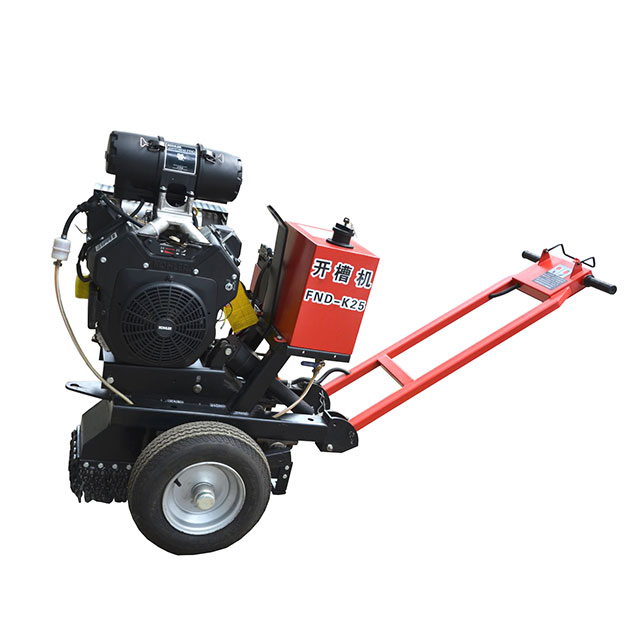

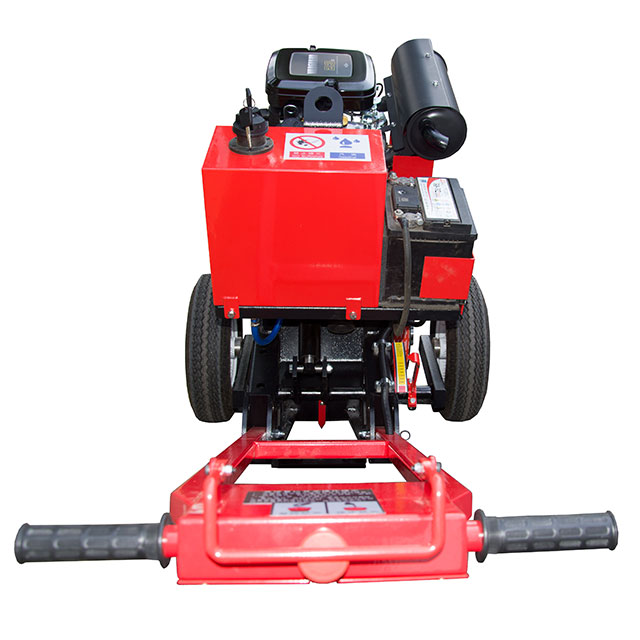

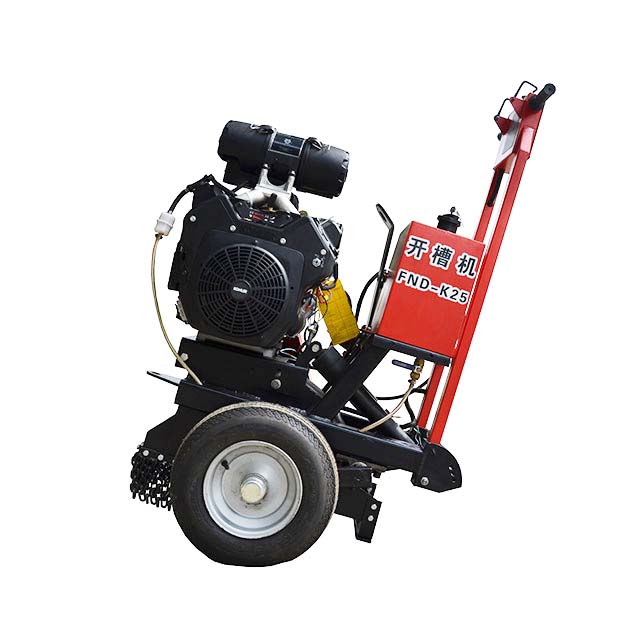

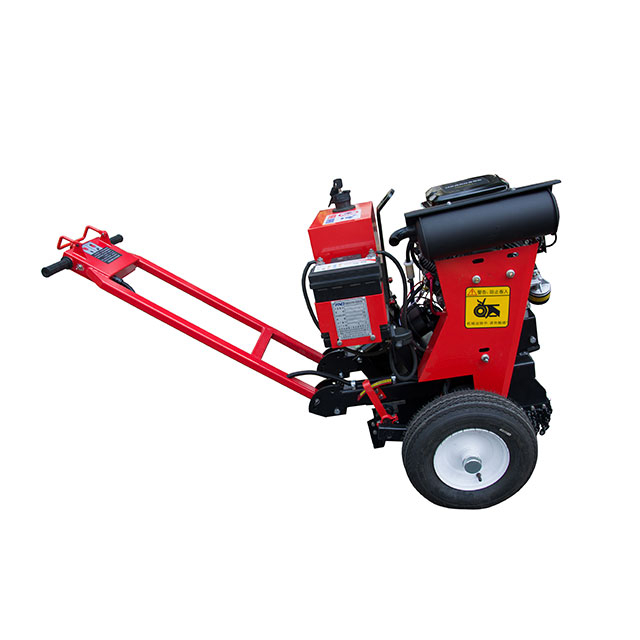

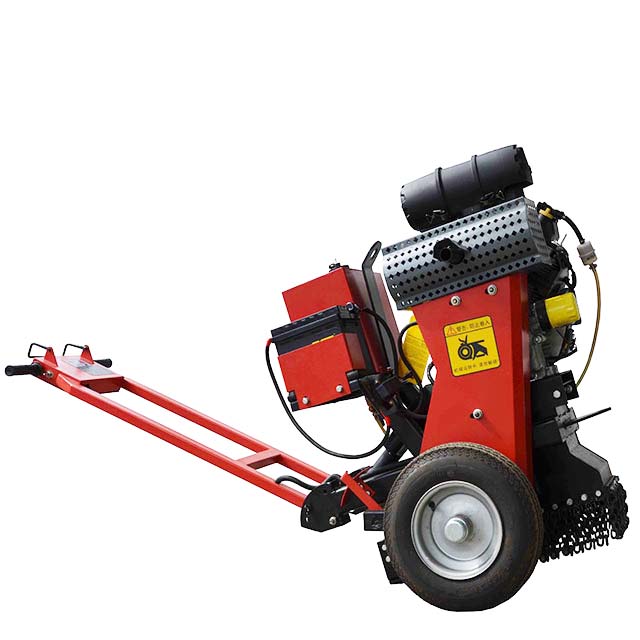

FND-K25
1. Adjustable cutting depth 0-3cm & width 1-5cm, works on asphalt & concrete for various crack-sealing standards Fully adjustable depth 0-3 cm, width 1-5 cm for standard sealing grooves. One machine fits both asphalt and concrete pavement, avoiding extra equipment investment for budget-limited projects.
2. Operator-tilt emergency brake with 7-second fast stop for on-site safety & accident-loss prevention Automatic stop triggered when operator loses balance within 7 seconds. Reduces mechanical-injury risks during hand-propelled operation and avoids project halt or compensation caused by safety incidents.
3. Light-weight 225 kg hand-push design for flexible relocation on scattered crack locations 225 kg hand-propelled unit, no heavy transport truck required. Fast positioning for scattered highway & municipal cracks, saving transfer time and improving daily preventive-maintenance output.
Project Background: Rural road crack-treatment project in suburban Buenos Aires, Argentina. Total crack-routing length 18 km. Tight procurement budget, loose local dust-control requirements for countryside sites. Both asphalt and concrete pavements with widely scattered cracks. Works consist of routing followed by preventive crack sealing.
Project Location: Suburban county-town road network, Buenos Aires, Argentina
Challenges
1. Limited capital budget, dust-collection function not required, target to lower equipment purchase cost.
2. Crack depth & width varied. Old machines with fixed groove size produced poor-quality cuts, leading to high sealant peeling & re-repair rate.
3. Legacy machines had no emergency stop. Operator-slipping created mechanical-injury hazards for hand-push operation.
4. Crack spots were widely scattered. Heavy equipment caused long transfer delays. Lightweight hand-propelled router was required.
5. Both asphalt and concrete pavement existed on-site, single-machine multi-surface capability was expected.

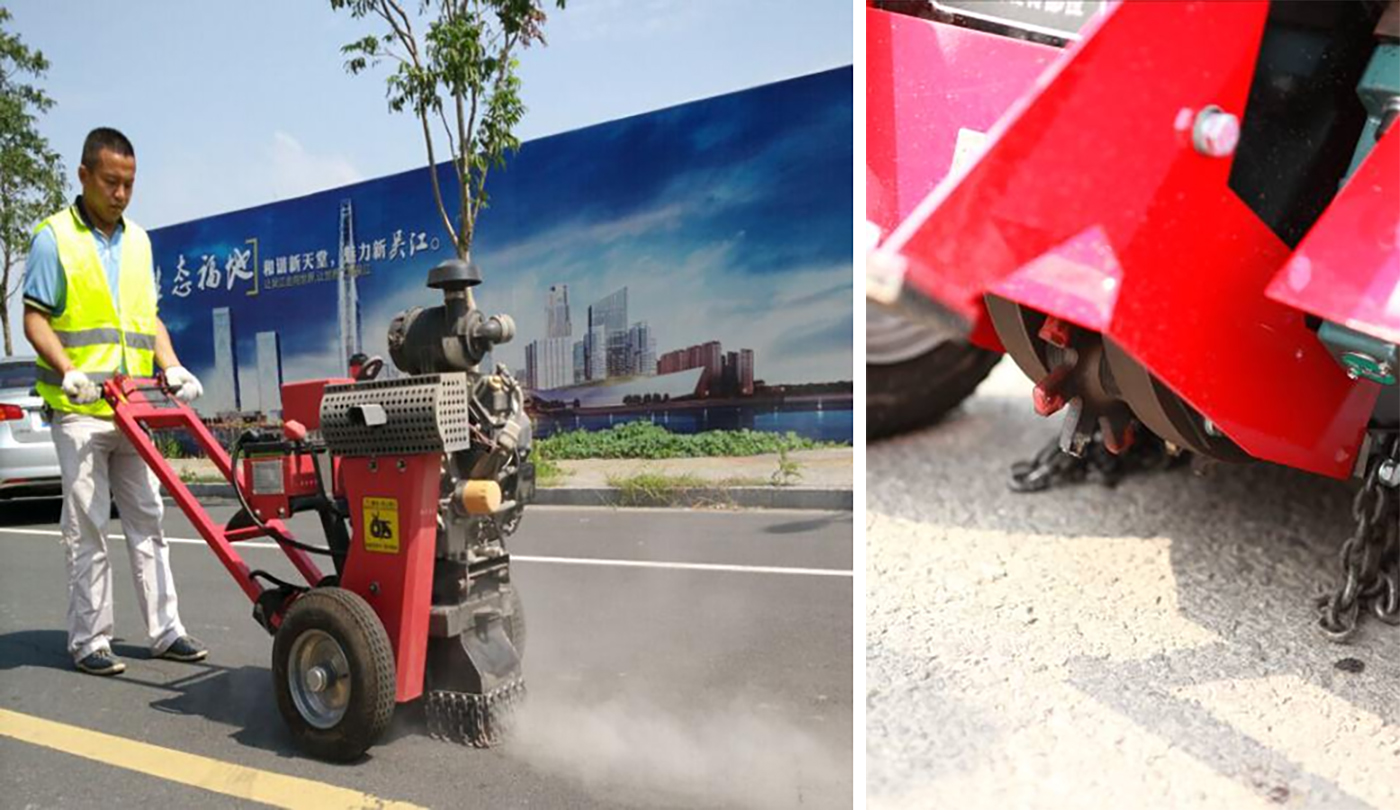

Solution: Four units of FND-K25 basic crack router were deployed. Kohler engine with 3-stage air filter handled dusty field environment. Adjustable 0-3 cm depth & 1-5 cm width created qualified sealing grooves. Tilt-activated 7-second emergency brake protected operators. Hand-push mobility served scattered work locations. Each unit performed routing on asphalt and concrete and cooperated with crack fillers.
Project Outcome: Full routing scope completed with lower procurement investment. Emergency-brake function mitigated injury risk. Well-shaped grooves guaranteed sealing quality. Compact hand-push design fitted scattered rural sites. 18 km routing work finished on schedule. Post-repair sealing performance was qualified and re-repair rate dropped obviously.


Model | FND-K25 |
External dimensions | 1100*850*1500MM L*W*H |
Whole machine weight | 235kg |
Engine part | |
Engine | CH740 |
rated power | 25HP |
Fuel tank capacity | 25L |
Control and cutting system | |
Slot depth control | Imported lifting controller |
Storage battery | 12V 55AH |
Why do we need the road crack cutting machine when repairing road cracks?
Whether to first groove and then use pavement sealant to repair road cracks mainly depends on the width and severity of the cracks, and corresponding treatment methods should be determined based on the severity of the defects.
Based on our past construction experience, if the width of a road crack is more than half a centimeter, it must be treated with slot expansion. After the width and depth of the slot expansion meet the requirements, the width should be 1-1.2 centimeters and the depth should be 1 Remove the aged and loose old gravel at the edge of the crack (2-1.5 cm), blow it dry, and make sure the crack is kept dry. Then, use road sealant to fill the crack and repair it. This treatment can avoid the weak bonding between the road sealant and the crack wall edge, which affects the sealing and waterproofing effect.
If the width of road cracks is less than half a centimeter, other corresponding measures should be taken to deal with it.
1.Acceptance shall be conducted in accordance with the technical performance parameters provided by the Supplier, with complete and intact accompanying technical documents including product manuals and other relevant materials.
2. After the equipment arrives at the location designated by the Buyer, the Buyer shall arrange goods acceptance on the same day. Hand‑over formalities shall be completed if no objection is raised upon qualified acceptance. Any quality objection shall be submitted in writing within two (2) days upon goods arrival for mutual negotiation and resolution between both parties. If no written quality objection is raised by the Buyer within three (3) days after goods arrival due to the Buyer’s reasons, the equipment shall be deemed as accepted.
The Supplier shall arrange logistics to deliver the equipment to the location designated by the Buyer. Freight costs shall be borne by the Buyer. The Buyer shall be responsible for the unloading and acceptance of the equipment.
